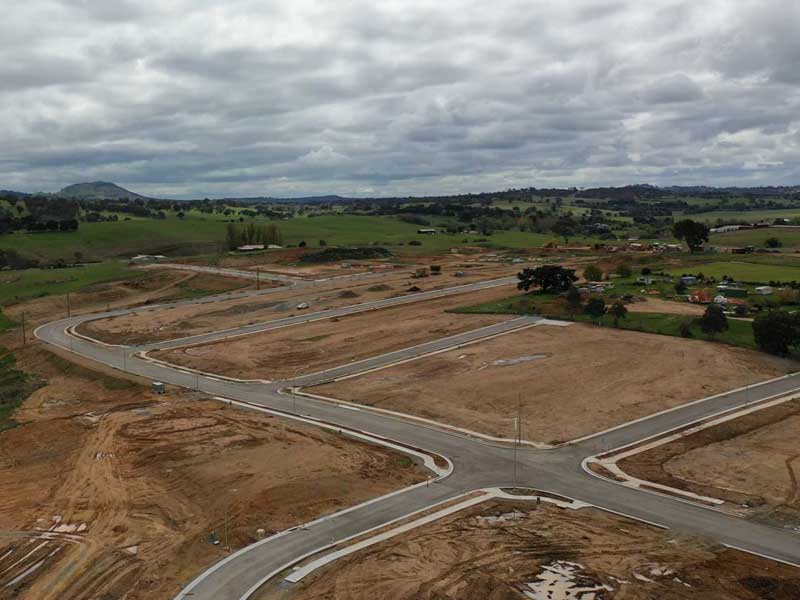

Week 58 progress report is for work completed up to the end of October. Works completed up to Week 58 included:
-
Monitoring of safety, environmental, erosion and quality controls;
-
100% topsoil stripping completed;
-
100% earthworks cut and fill completed;
-
100% sewer trenching, pipe installation and construction of sewer manholes completed;
-
100% stormwater pipes layed and 100% stormwater pits installed;
-
100% sewer pump station components completed;
-
100% watermain works commenced and 100% of water services with connection still to occur;
-
100% subsurface drains completed;
-
100% demolition of entry house and clearing works completed;
-
100% road subbase construction completed;
-
100% kerb & gutter completed;
-
100% NBN installation completed;
-
100% sewer rising main installation completed;
-
99% electrical works completed;
-
90% footpaths completed;
-
85% topsoiling of lots and verges;
-
100% final road wearing courses;
-
100% retaining walls;
-
80% tree planting and general landscaping;
-
50% Intersection, entry feature and entry landscaping.
