Yarrah September 2026 Progress Report

17 September 2026 Yass Valley, NSW
The Yass River curving through green pasture below low hills at Yarrah, with farm buildings on the far ridge.

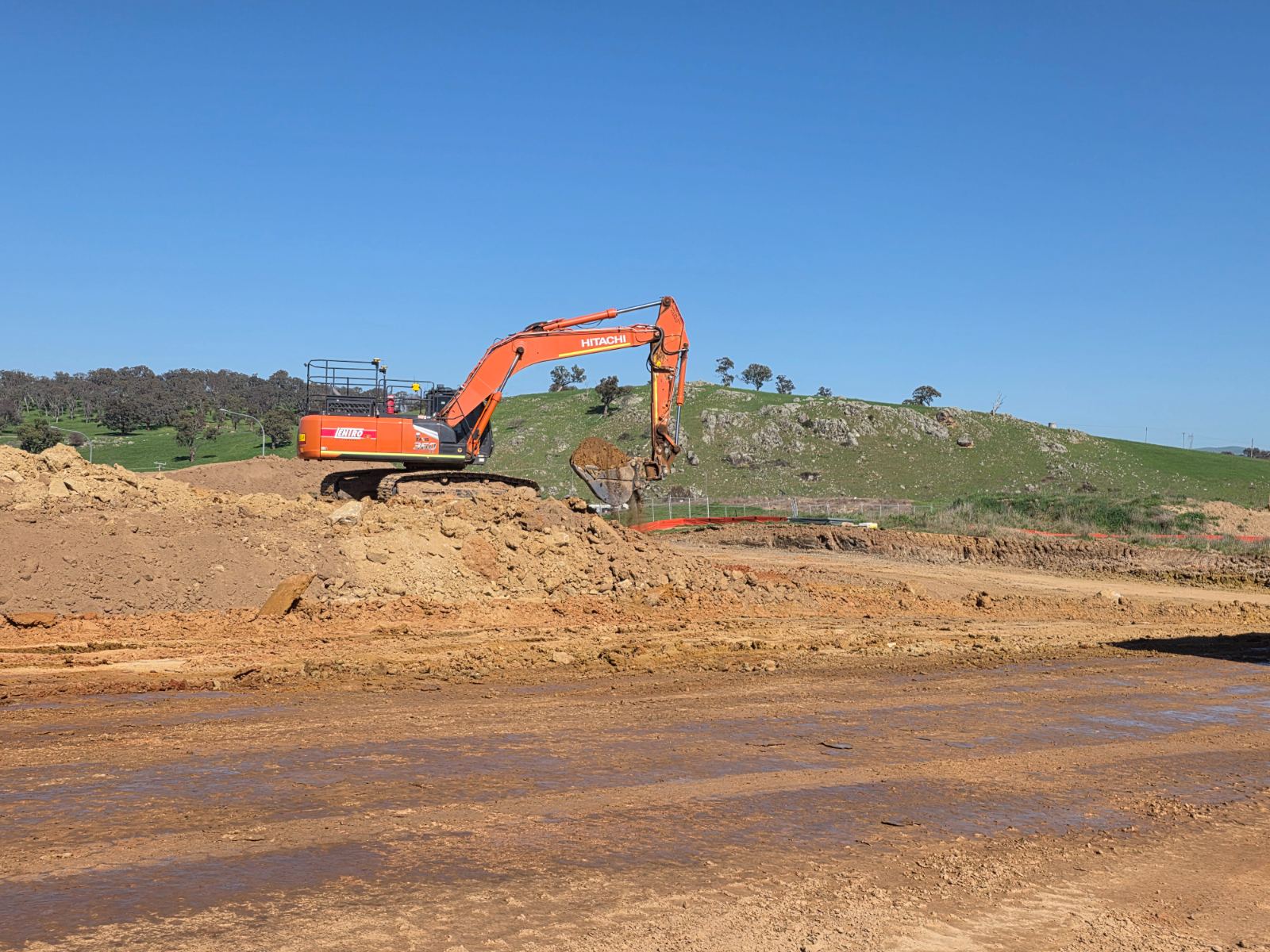

Stage 3 bulk earthworks on the high point above Yarrah Drive.

Spring has arrived and Yarrah pushes ahead with two stages under construction.

Spring has arrived and Yarrah pushes ahead with two stages under construction.

Stage 2B. The earthworks program is behind us and services are now going into the ground. Practical completion is programmed for end of October.

Stage 3. Site works commenced in August and are moving quickly. Topsoil stripping is well advanced and bulk earthworks are under way across the stage.

Stage 2B. The earthworks program is behind us and services are now going into the ground. Practical completion is programmed for end of October.

Stage 3. Site works commenced in August and are moving quickly. Topsoil stripping is well advanced and bulk earthworks are under way across the stage.

Together, these milestones continue Yarrah's steady transition from an emerging neighbourhood into a growing, connected community.

Together, these milestones continue Yarrah's steady transition from an emerging neighbourhood into a growing, connected community.

The first half of the year has brought strong and visible progress across Yarrah. New homes are being completed throughout the established streets of Stages 1 and 2A, while earthworks commenced in Stage 2B in March. The Subdivision Works Certificate for Stage 3 has now been secured, and the corresponding application for Stage 4 has been lodged with Council. Together, these milestones reflect Yarrah’s continued transition from an emerging neighbourhood into a growing, connected community.

In this report
01 Stage 1 Homes under way

Each home its own.

What stands out in Stage 1 this spring is the variety: render, brick and weatherboard frontages sitting side by side, no two homes the same. The lots on the outer edge back straight onto open space, with the river corridor and the hills beyond them a short walk away.

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Woods Street is starting to fill out.
A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Woods Street is starting to fill out.
A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Woods Street is starting to fill out.
01 Stage 1 Homes under way

Each home its own.

What stands out in Stage 1 this spring is the variety: render, brick and weatherboard frontages sitting side by side, no two homes the same. The lots on the outer edge back straight onto open space, with the river corridor and the hills beyond them a short walk away.

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Woods Street is starting to fill out.
A footpath running beside a landscaped verge with grasses and shrubs in an established Yarrah street.
Stage 1 street trees in full blossom in front of completed homes
Serviced lots at Yarrah with kerbs, street lighting and new plantings in place, looking across to green grazing hills and scattered gum trees.
The Yass River corridor, overlooking the iconic Clifton Wood
02 Stage 2B In progress

Services in, roads next.

The graders have moved on and the trenching crews have taken their place. Sewer lines, cut and fill earthworks and subgrade preparation are now complete across the stage, and electrical and NBN conduits are in the ground. Stormwater installation is 95% complete, and topsoiling of the blocks and batters is progressing well. The road select layer and the water mains follow next, with practical completion programmed for 30 October.

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.

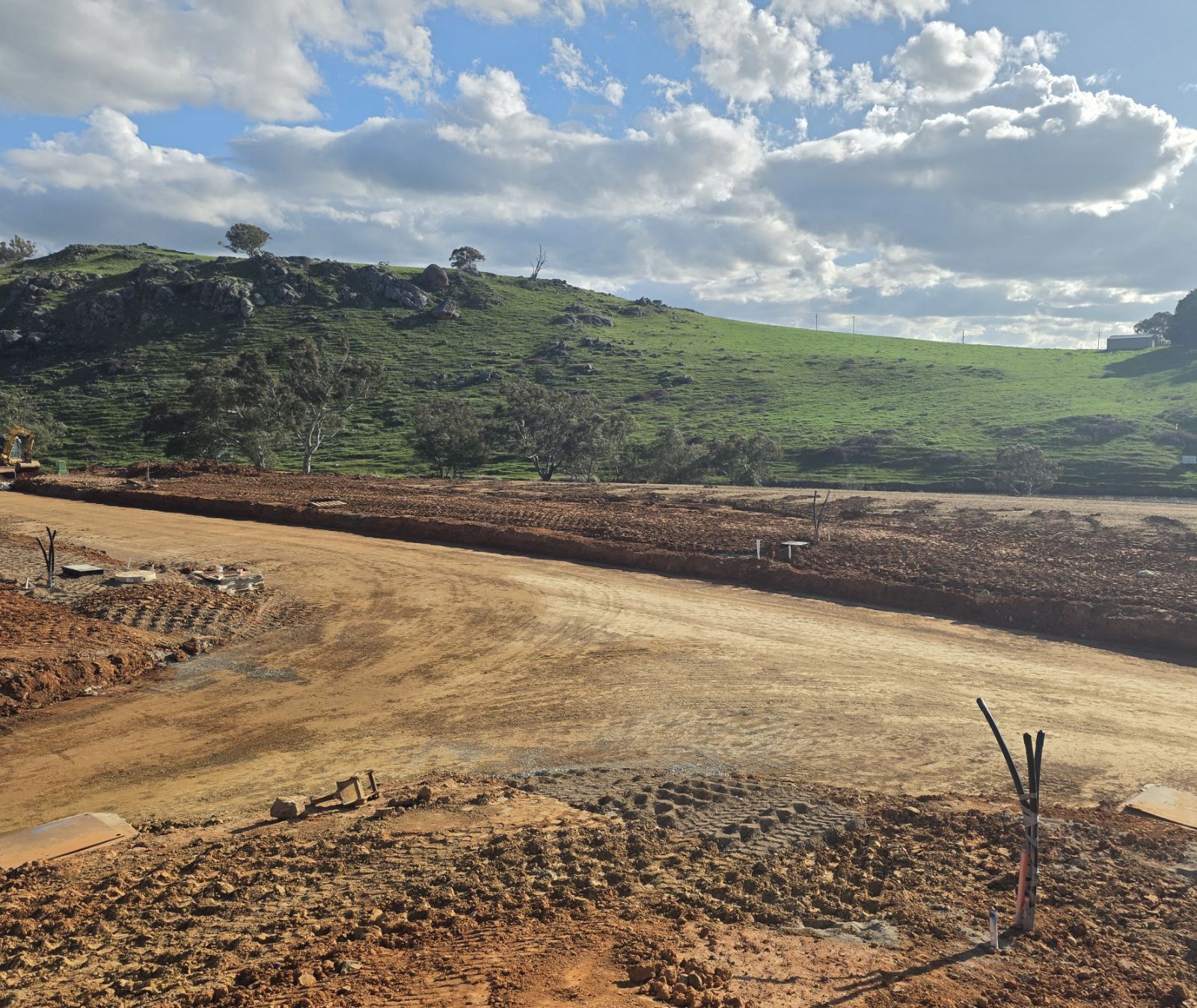

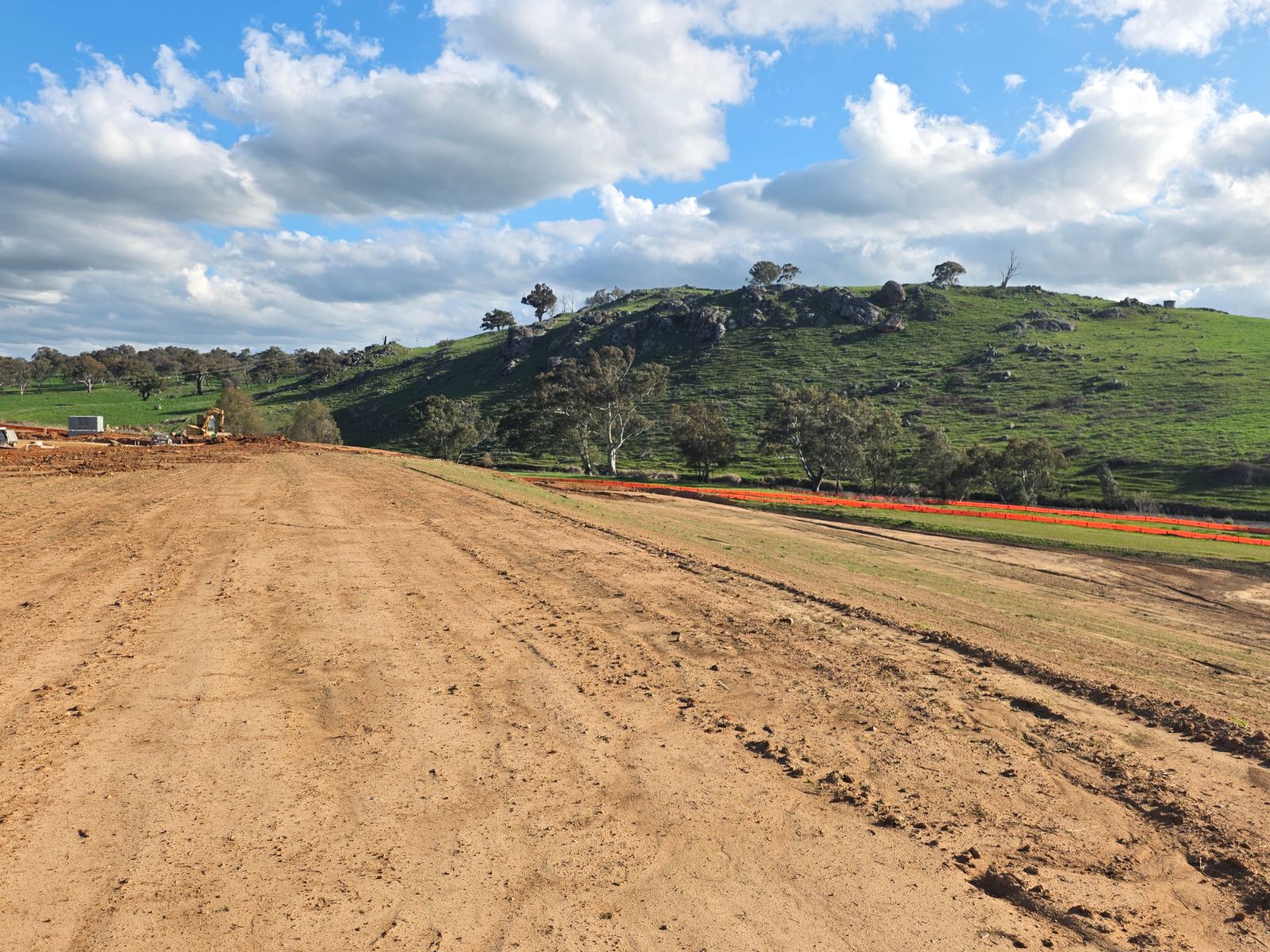

Stage 2B topsoiling of blocks and batters, sediment controls in place
A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Stage 2B topsoiling of blocks and batters, sediment controls in place
A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Stage 2B topsoiling of blocks and batters, sediment controls in place
02 Stage 2B In progress

Services in, roads next.

The graders have moved on and the trenching crews have taken their place. Sewer lines, cut and fill earthworks and subgrade preparation are now complete across the stage, and electrical and NBN conduits are in the ground. Stormwater installation is 95% complete, and topsoiling of the blocks and batters is progressing well. The road select layer and the water mains follow next, with practical completion programmed for 30 October.

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Stage 2B topsoiling of blocks and batters, sediment controls in place
A footpath running beside a landscaped verge with grasses and shrubs in an established Yarrah street.

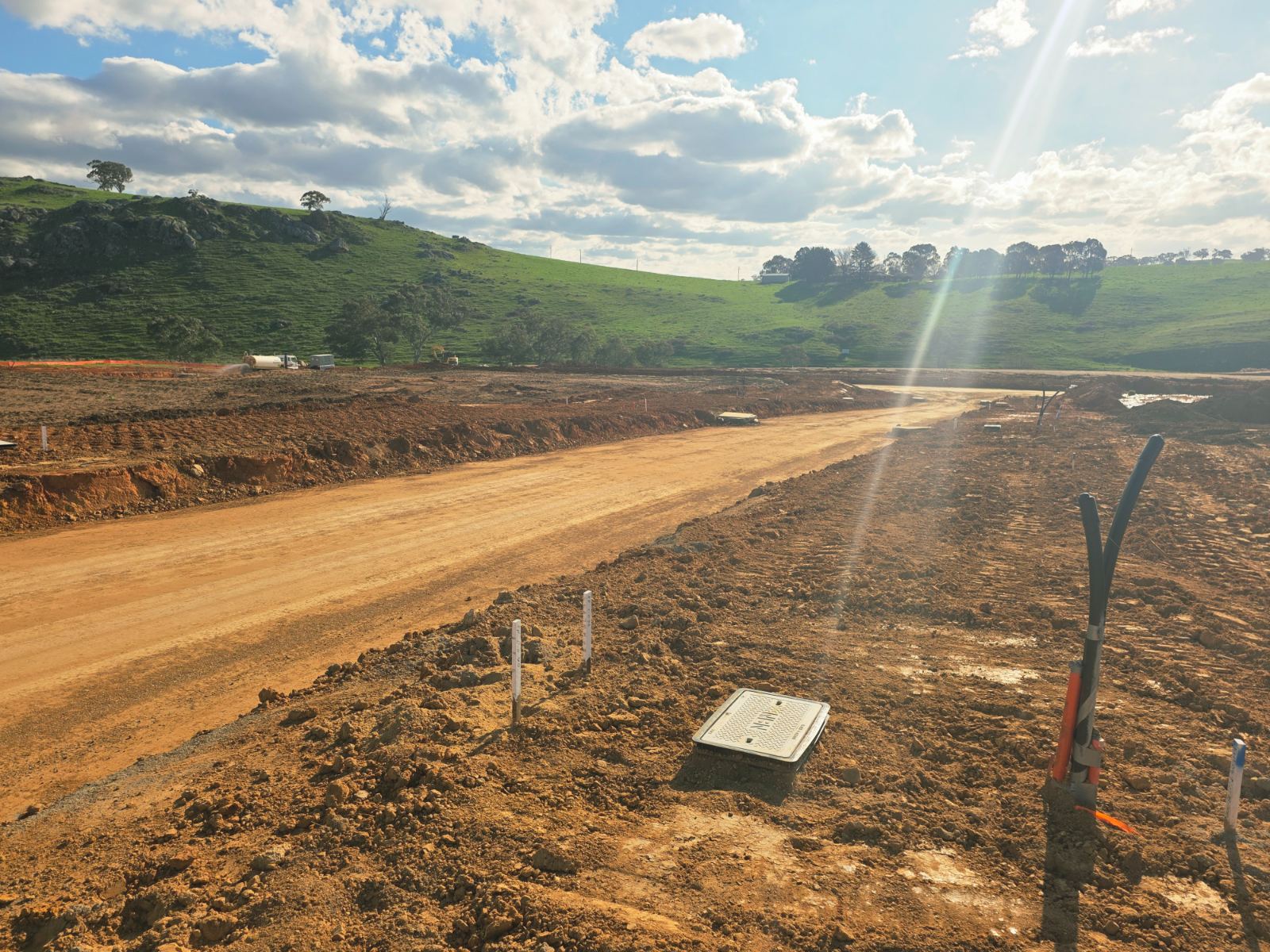

Stage 2B road formation with NBN pit and conduits installed
Serviced lots at Yarrah with kerbs, street lighting and new plantings in place, looking across to green grazing hills and scattered gum trees.
Stage 2B subgrade trimming ready for select material placement
03 Stage 3 In progress

Earthworks well under way.

Site works commenced in August and Stage 3 is now a working site. Erosion and sediment controls are in place across the stage, topsoil stripping is well advanced, and bulk earthworks are progressing across the higher ground. Earthworks continue to next week, with the sewer to follow.

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.

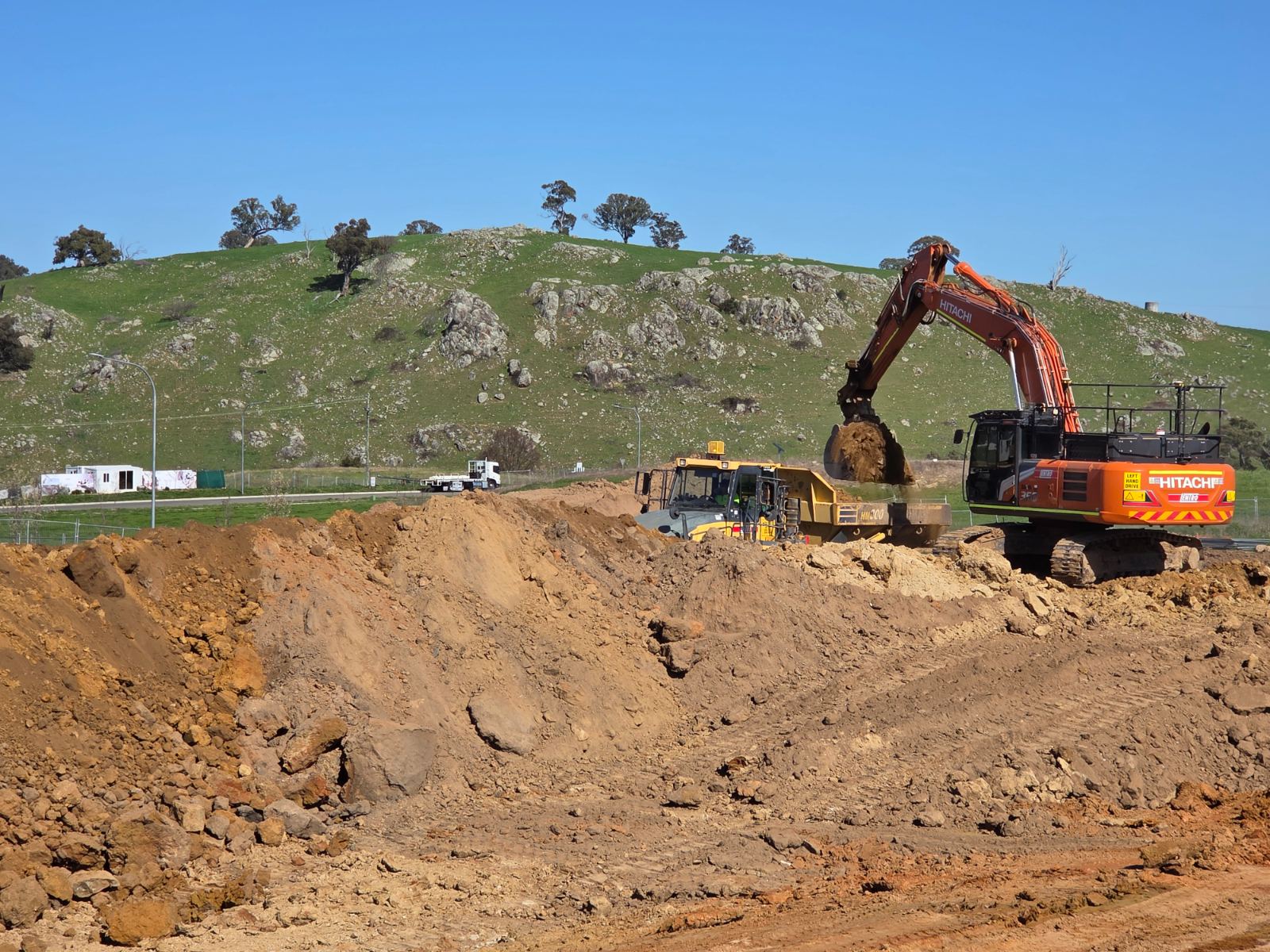

Stage 3 topsoil almost complete and the D8 is undertaking bulk earthworks, looking back over the Stage 1 established streets

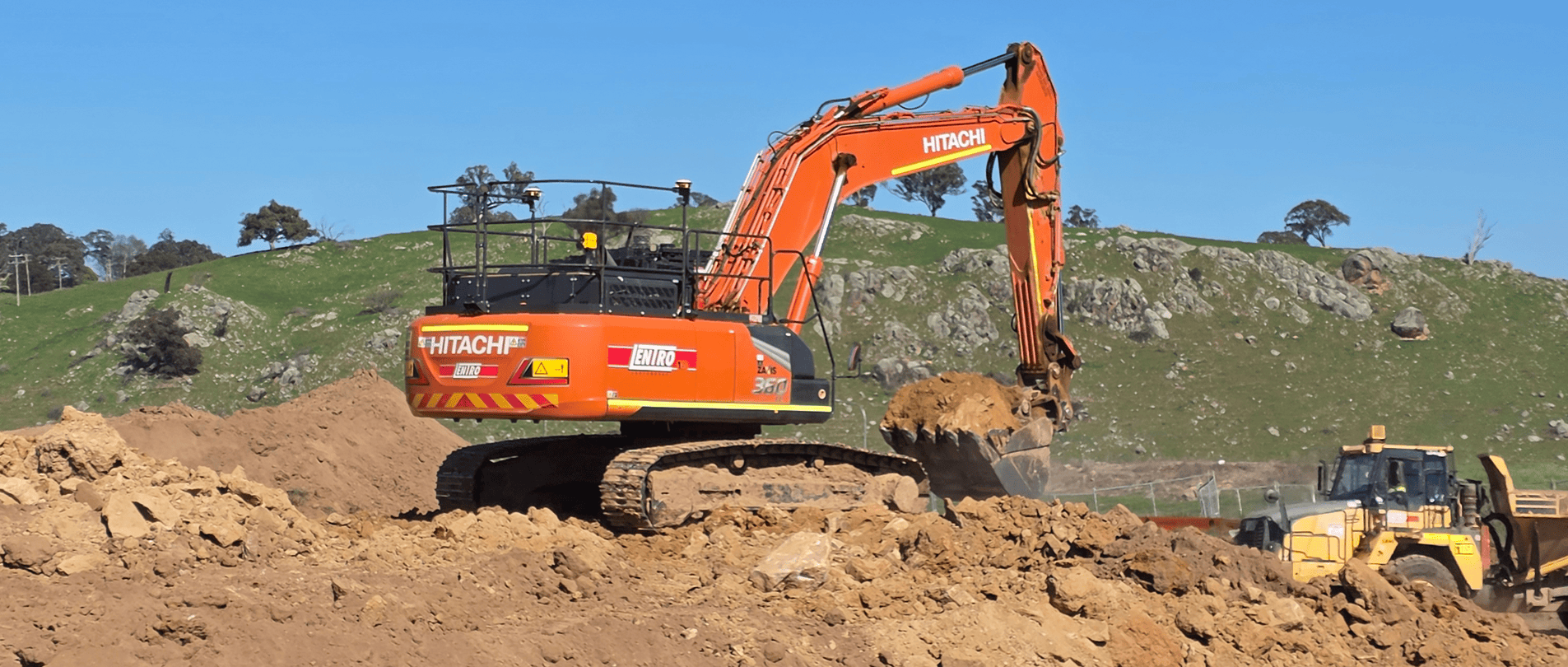

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.

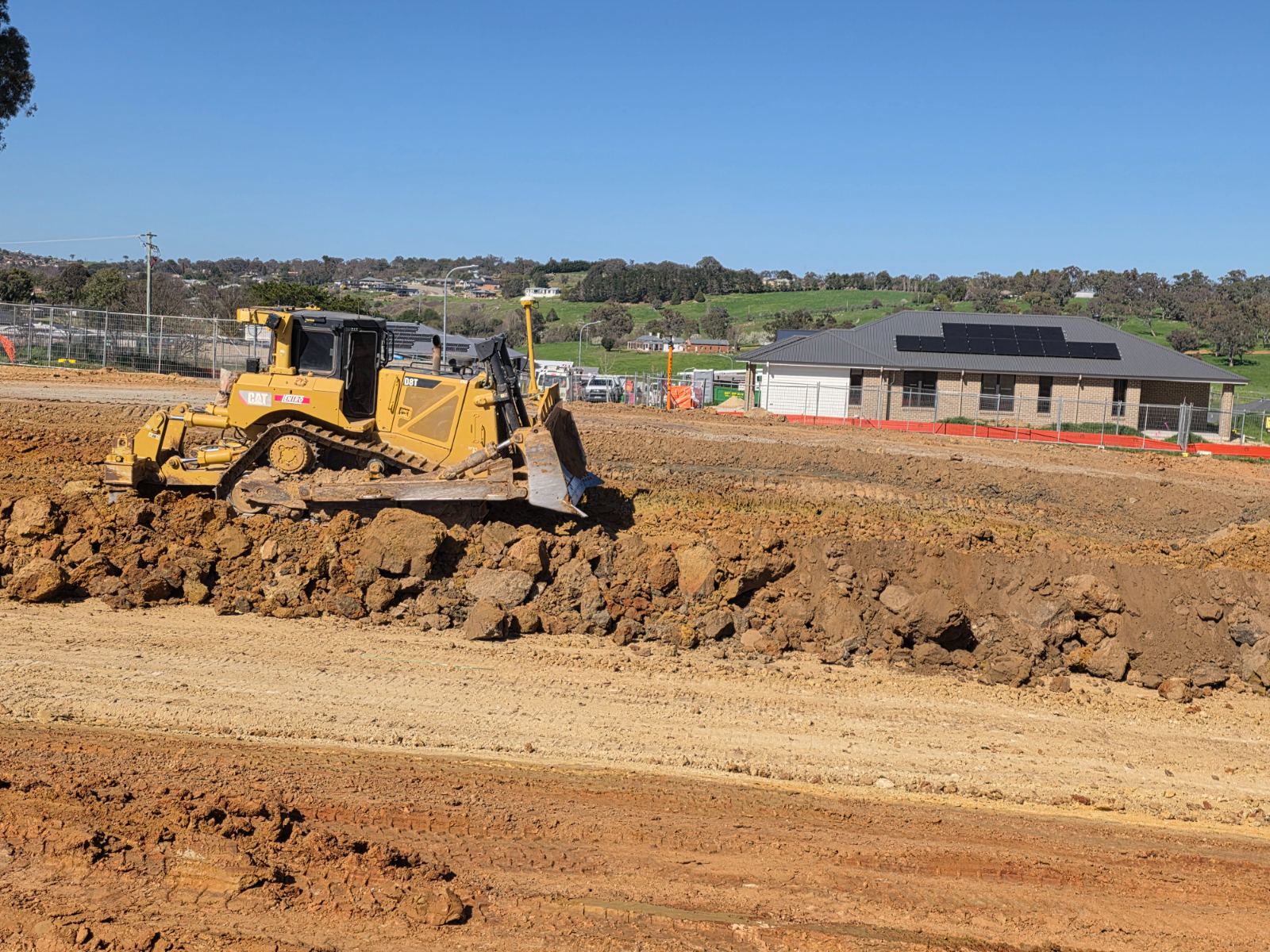

Stage 3 topsoil almost complete and the D8 is undertaking bulk earthworks, looking back over the Stage 1 established streets
A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Stage 3 topsoil almost complete and the D8 is undertaking bulk earthworks, looking back over the Stage 1 established streets
03 Stage 3 In progress

Earthworks well under way.

Site works commenced in August and Stage 3 is now a working site. Erosion and sediment controls are in place across the stage, topsoil stripping is well advanced, and bulk earthworks are progressing across the higher ground. Earthworks continue to next week, with the sewer to follow.

A completed two-storey home at Yarrah in white render with black-framed windows, a double garage, lawn and a gravel garden bed planted with grass trees.
Stage 3 topsoil almost complete and the D8 is undertaking bulk earthworks, looking back over the Stage 1 established streets
A footpath running beside a landscaped verge with grasses and shrubs in an established Yarrah street.
Stage 3 cut material carted across the stage
Serviced lots at Yarrah with kerbs, street lighting and new plantings in place, looking across to green grazing hills and scattered gum trees.
Stage 3 earthworks progressing above the river corridor lots
What's next

Stage 3's first Estate homes are now available.

The Yarrah Team.
